Recent Weekly Highlights
11/11/2024 through 11/29/2024
Site Activities as follows by Prime Contractor: Cianbro and Subcontractor: Ranger
- Completed sidewalk placements for phase 1.
- Placed the approach slab on the Waterville side.

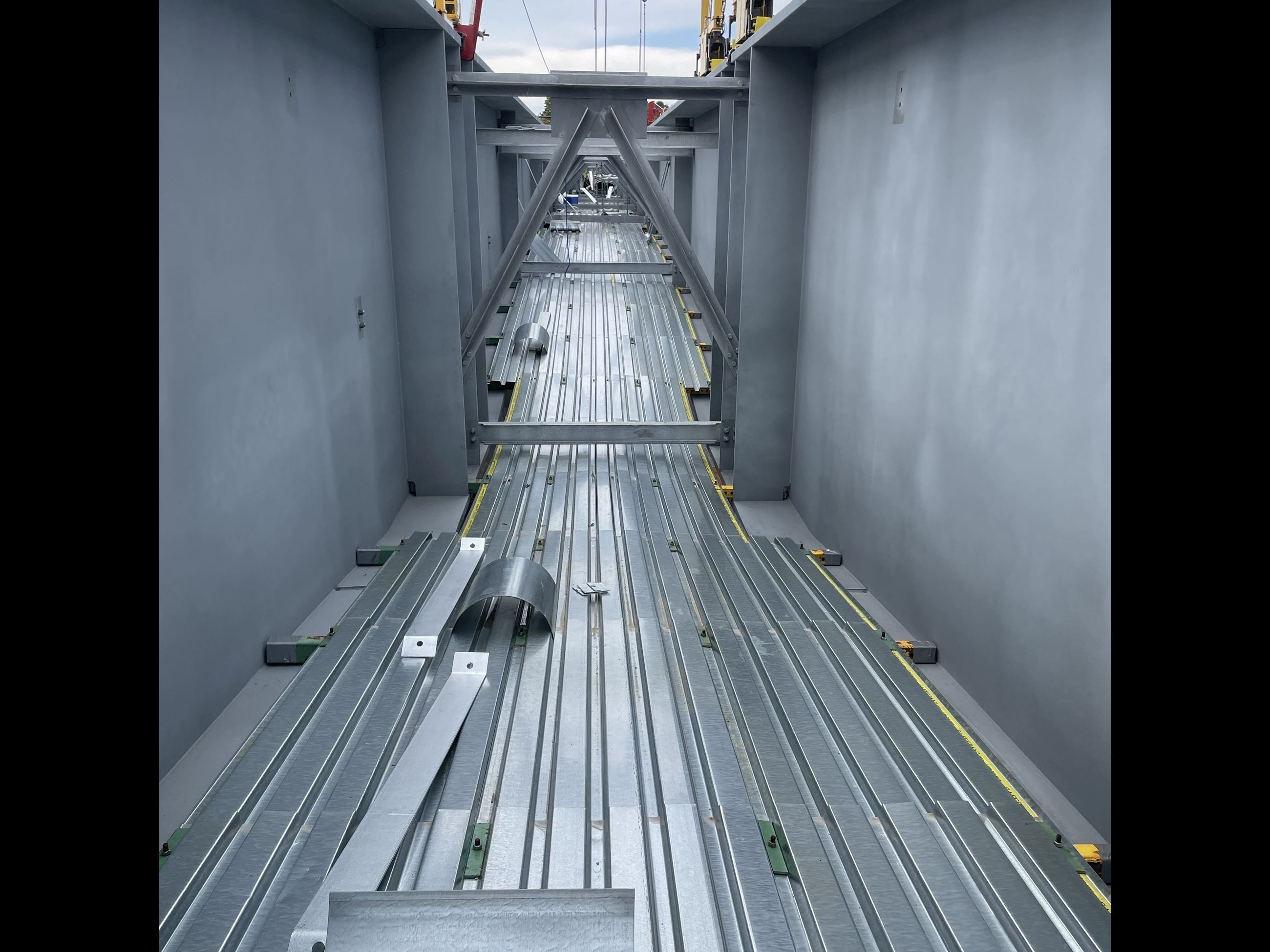

- Removed forms for the bridge deck.
- Continued work on CMP duct bank.
- Started installing forms for the curb.
- Finished Water main installation on the Waterville side.
(MaineDOT Resident: Ben Walz )
11/04/2024 through 11/08/2024
Site Activities as follows by Prime Contractor: Cianbro and Subcontractors: Suncoast reinforcing, And Ranger
- Placed the last footing for abutment 2 wingwall for phase 1.
- Continued working on sidewalk forms.
- Continued watermain installation on the Waterville side.
- Placed the 1st section of sidewalk for phase 1.
- Started rebar installation for abutment 2 wingwall.
- Re-installed the temporary ADA ramp for the pedestrian detour.
(MaineDOT Resident: Ben Walz )
10/21/2024 through 11/01/2024
Site Activities as follows by Prime Contractor: Cianbro and Subcontractors: Suncoast reinforcing, and Ranger
- Completed the 2nd footing placement abutment 2 wingwall.
- Started installing forms for the 3rd footing at abutment 2.
- Continued sidewalk reinforcing bar installation and started installing forms.
- Finished reinforcing bar installation for the Winslow and center span.
- Completed the Winslow span and center span deck placement.
- Began watermain installation (Waterville side)
(MaineDOT Resident: Ben Walz)
10/14/2024 through 10/18/2024
Site Activities as follows by Prime Contractor: Cianbro and Subcontractor: Suncoast reinforcing
- Continued work installing forms for abutment 2 wingwall sub footing.
- Continued reinforcing bar installation on the bridge deck.
- Completed 1st concrete placement for the bridge deck.
- Continued work on gantry foundations.
(MaineDOT Resident: Ben Walz )
09/23/2024 through 09/27/2024
Site Activities as follows by Prime Contractor: Cianbro and Subcontractor: Ranger
- Continued installing forms for the bridge deck.
- Worked on demo at existing abutment 2.
- Installed CMP conduit and started installing forms for duct bank.
- Continued work on the gantry foundations.
- Continued work on the watermain.
(MaineDOT Resident: Ben Walz)
09/16/2024 through 09/20/2024
Site Activities as follows by Prime Contractor: Cianbro and Subcontractor: Ranger
- Placed the footing for gantry foundation D-2.
- Worked on installing the cofferdam for foundation E-2.
- Started installation of the watermain crossing the bridge.
- Worked on installing forms for the bridge deck.
- Excavated the area for CMP conduit installation.
(MaineDOT Resident: Ben Walz)

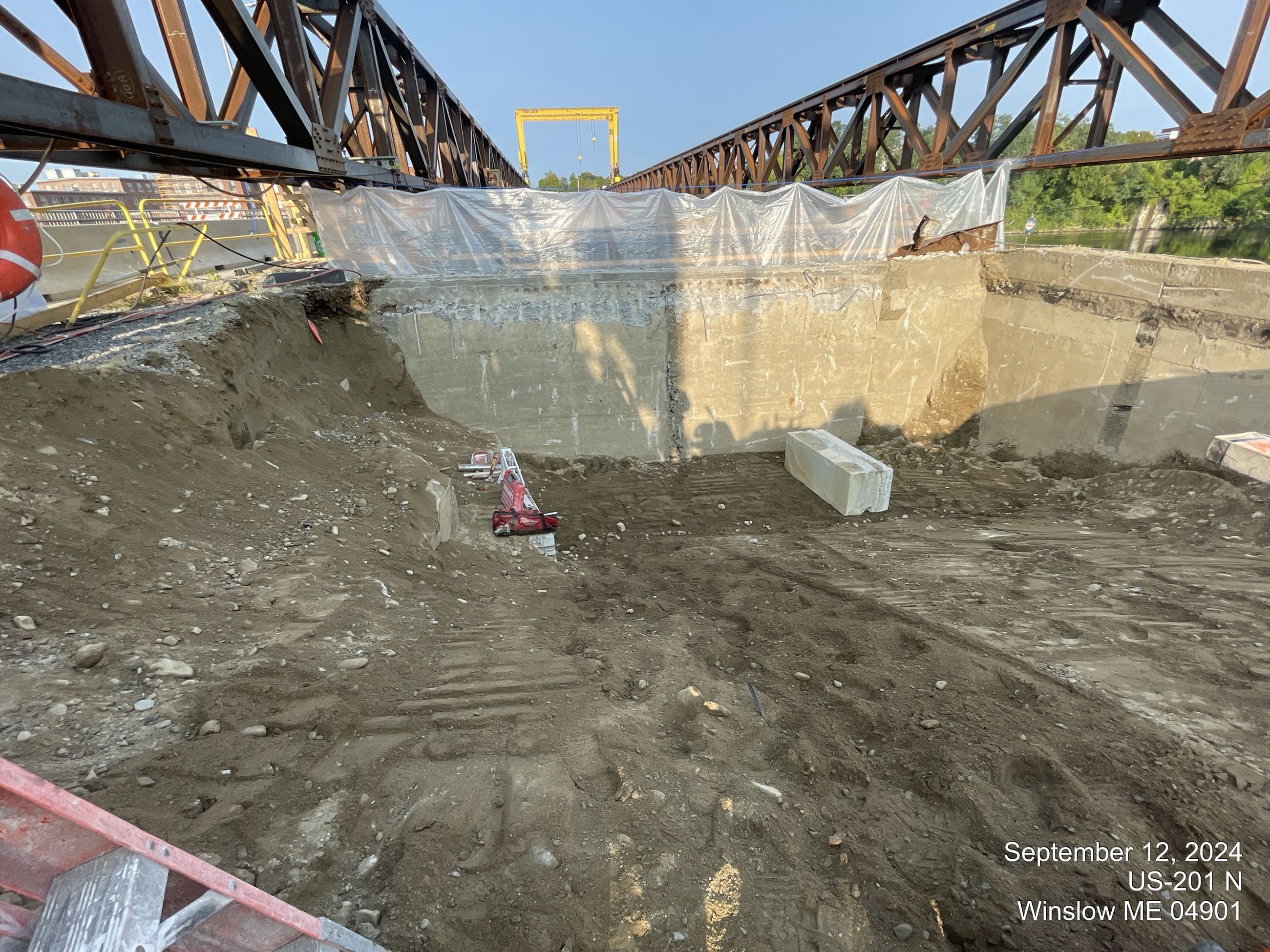

09/09/2024 through 09/13/2024
Site Activities as follows by Prime Contractor

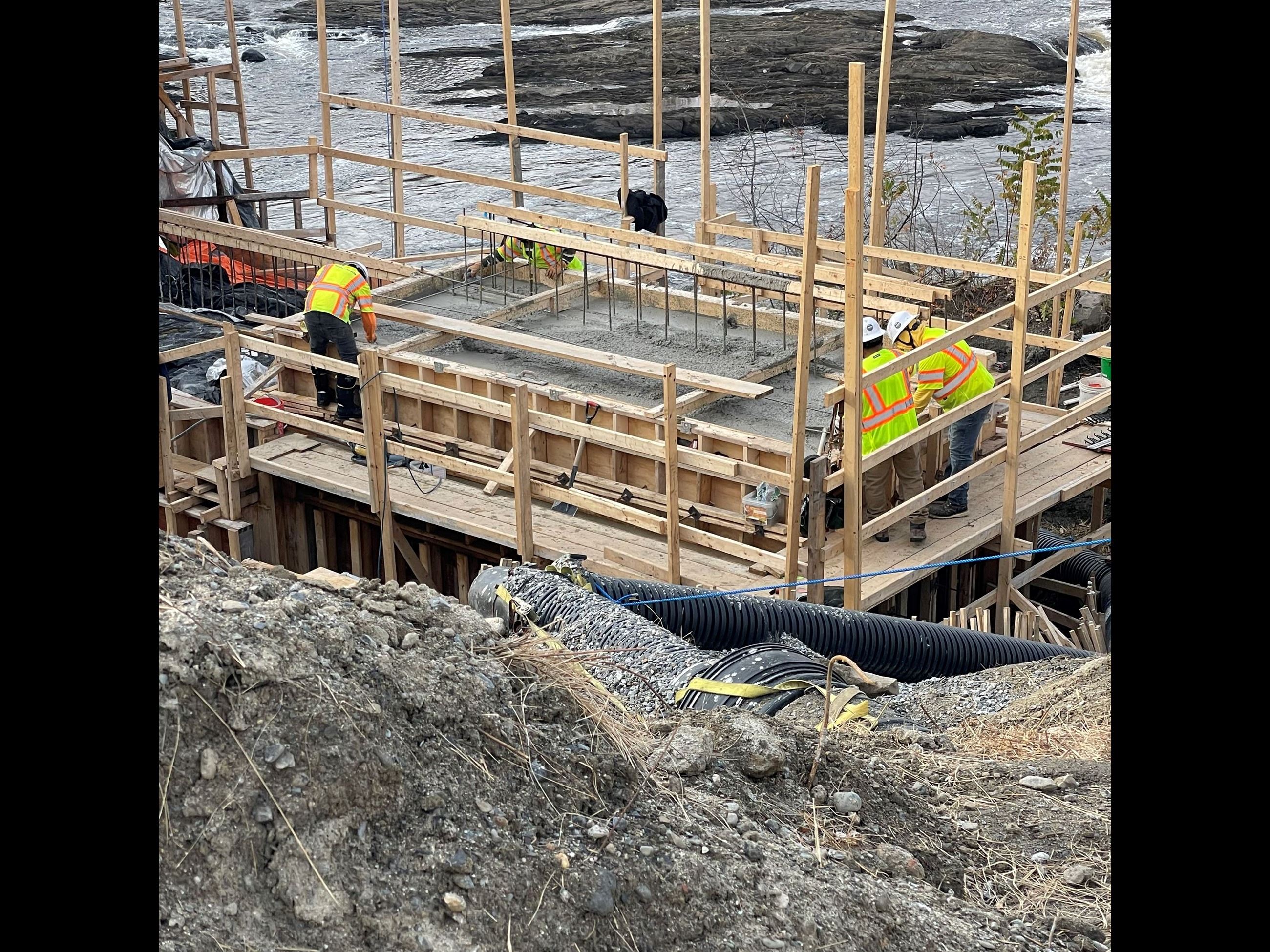

- Started excavation behind abutment 2, removed approach slab and started wire cutting old backwall.
- Continued working on stage 2 gantry truss, Placed the seal for foundation D-2
- Installed miradrain at abutment 1
- Surveyed blocking points.
(MaineDOT Resident: Ben Walz)
09/02/2024 through 09/06/2024
Site Activities as follows by Prime Contractor
- Continued steel erection for phase 1.
- Placed concrete for abutment 2 backwall.
- Resumed work on gantry foundations for phase 2 truss, installing cofferdam for foundation D-2.
(MaineDOT Resident: Ben Walz)
08/05/2024 through 08/09/2024
Site Activities as follows by Prime Contractor: Cianbro and subcontractor: L & D Safety Marking
- Continued wet cure on abutment 2 pedestals.
- Continued installing the backwall forms on abutment 1.
- Continued Steel erection, and bolt torquing.
- Re-applied the temporary pavement markings at Winslow intersection.
- Placed concrete for gantry foundation C-2, and continued work on foundation G-2.
(MaineDOT Resident: Ben Walz)
