April/May 2024

5/27/2024 through 5/31/2024

Site Activities as follows by Prime Contractor: Cianbro

  • Continued Structural steel removal on span 2 – Completed steel removal on span 4 and 3.
  • Continued work on abutment 1 – Installing access.

(MaineDOT Resident: Ben Walz)

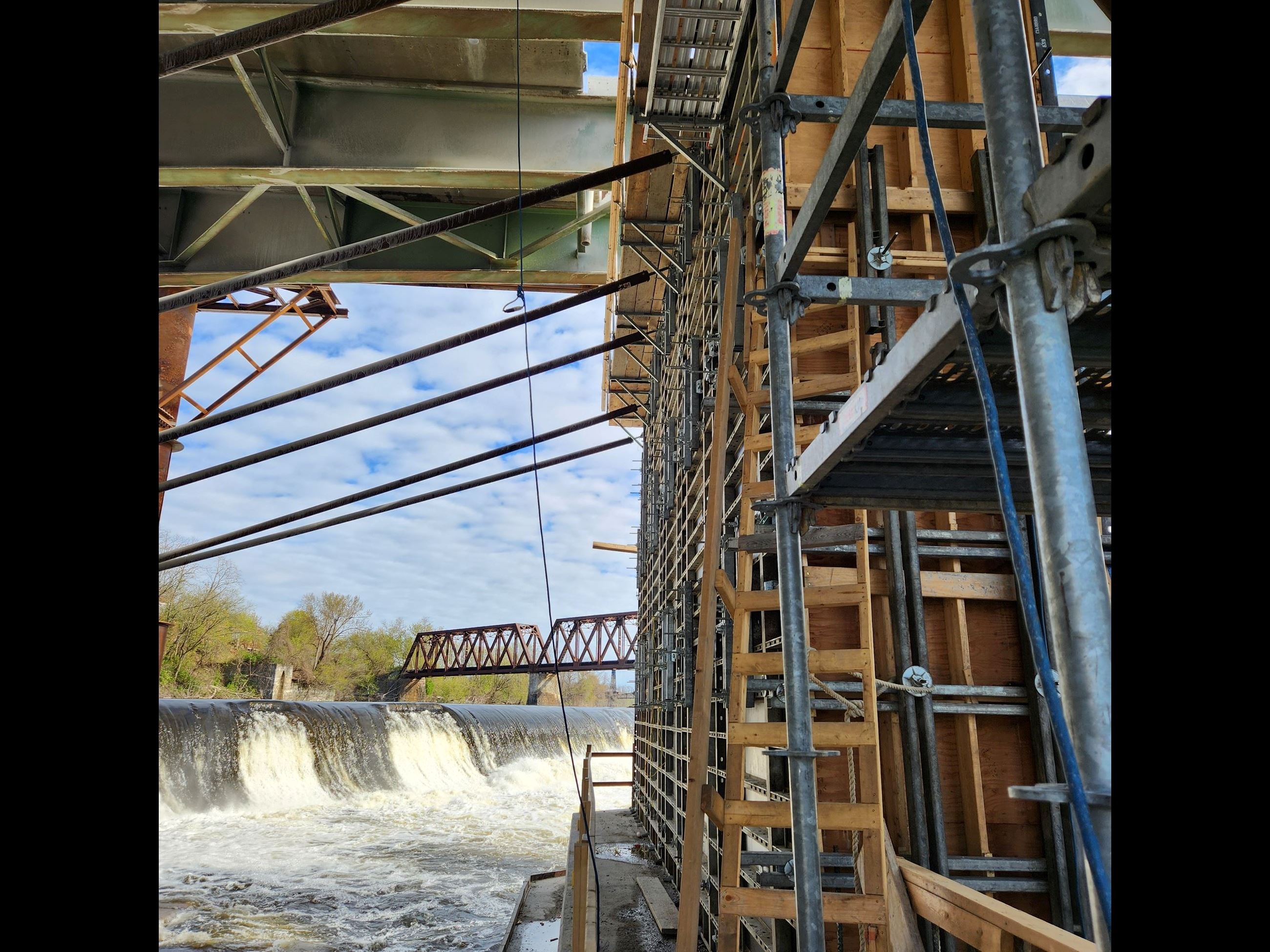

  1. 1 Ticonic Bridge Project
  2. 2 Ticonic Bridge Project
  3. 3 Ticonic Bridge Project

5/18/2024 through 5/23/2024

Site Activities as follows by Prime Contractor: Cianbro, Subcontractor: General Concrete Cutting

  • Completed Phase 1 deck removal.
  • Continued structural steel removal – removing span 4 girders.
  • Completed rebar and form installation and placed 2nd lift of Phase 1 of the pier.
  • Continued abutment 1 demo and structural earth excavation.

(MaineDOT Resident: Ben Walz)

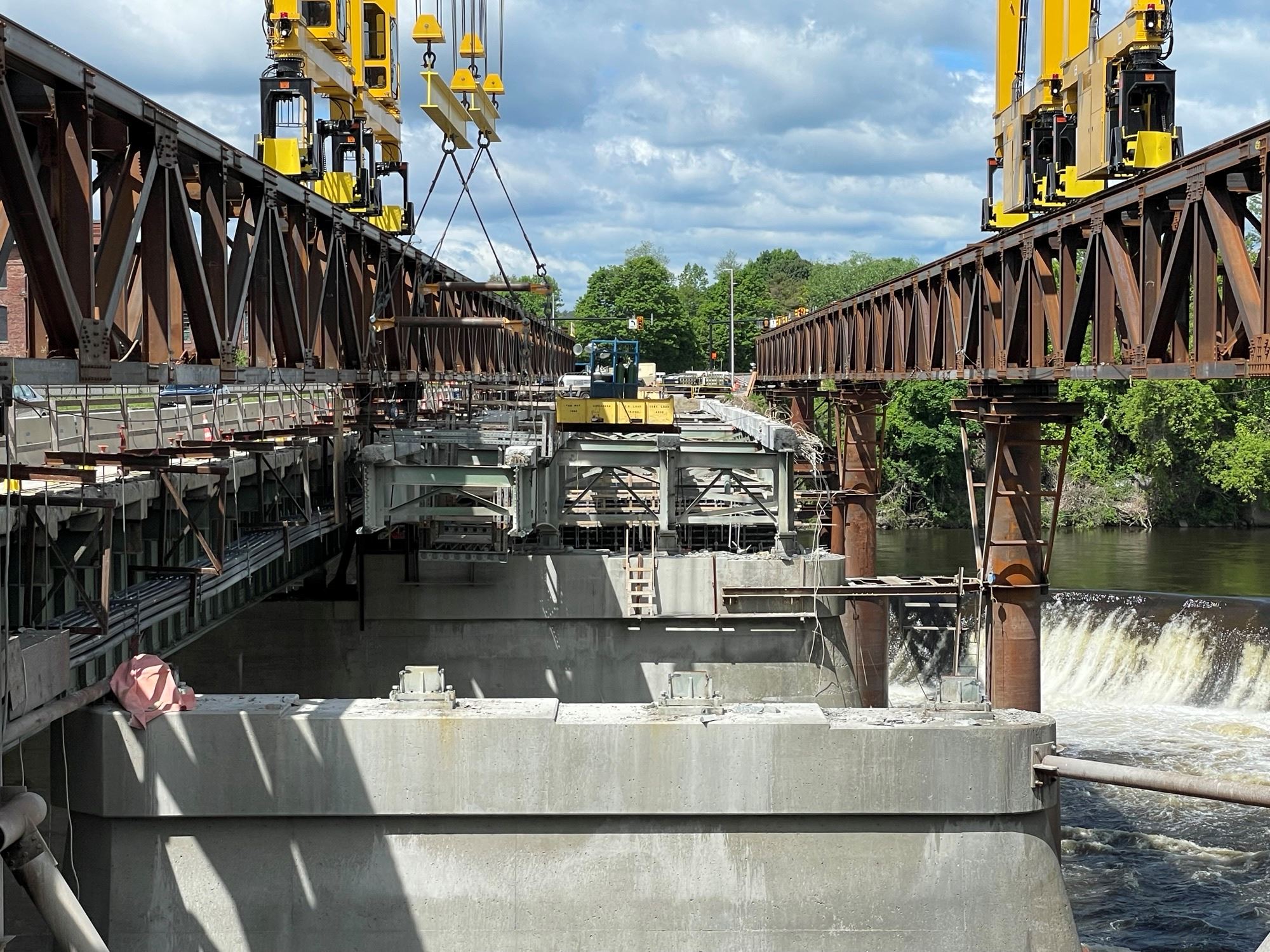

  1. 1 Ticonic Bridge Project
  2. 2 Ticonic Bridge Project

5/6/2024 through 5/10/2024

Site Activities as follows by Prime Contractor: Cianbro, Subcontractor: General Concrete Cutting

  • Continued saw cutting operation span 2.
  • Removed a pair of girders from span 5.
  • Continued installing rebar, forms and armor for the next lift of pier stem.
  • Worked on demo and structural earth excavation on abutment 1.

(MaineDOT Resident: Ben Walz)

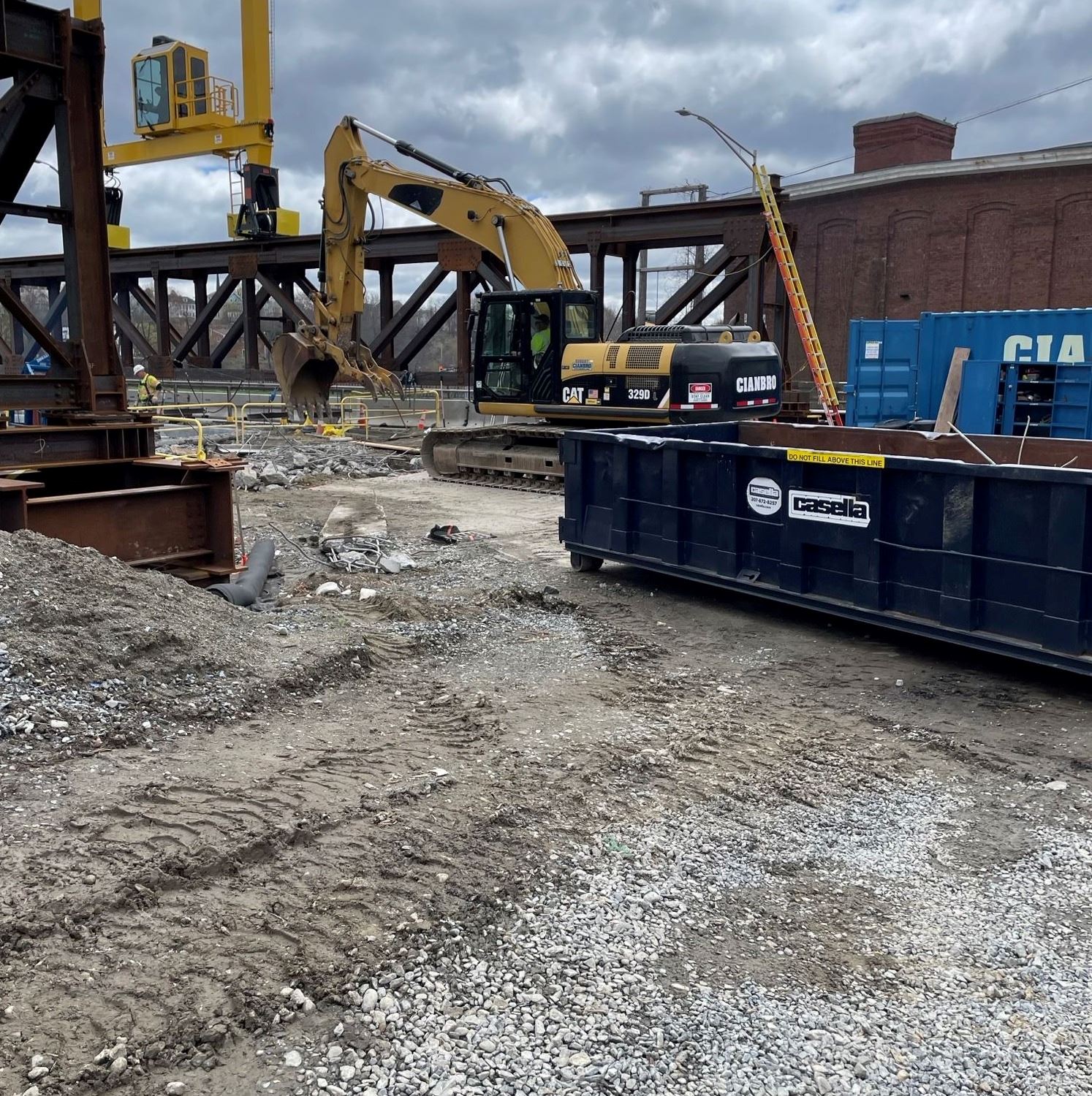

  1. 1 Ticonic Bridge Project
  2. 2 Ticonic Bridge Project
  3. 3 Ticonic Bridge Project
  4. 4 Ticonic Bridge Project

4/29/2024 through 5/3/2024

Site Activities as follows by Prime Contractor: Cianbro, Subcontractor: General Concrete Cutting

  • Continued saw cutting operation from abutment 1 to existing pier 1.
  • Removed girder pairs via gantry crane from abutment 1 to existing pier 1.
  • Started abutment 1 demo (Waterville)

(MaineDOT Resident: Ben Walz)

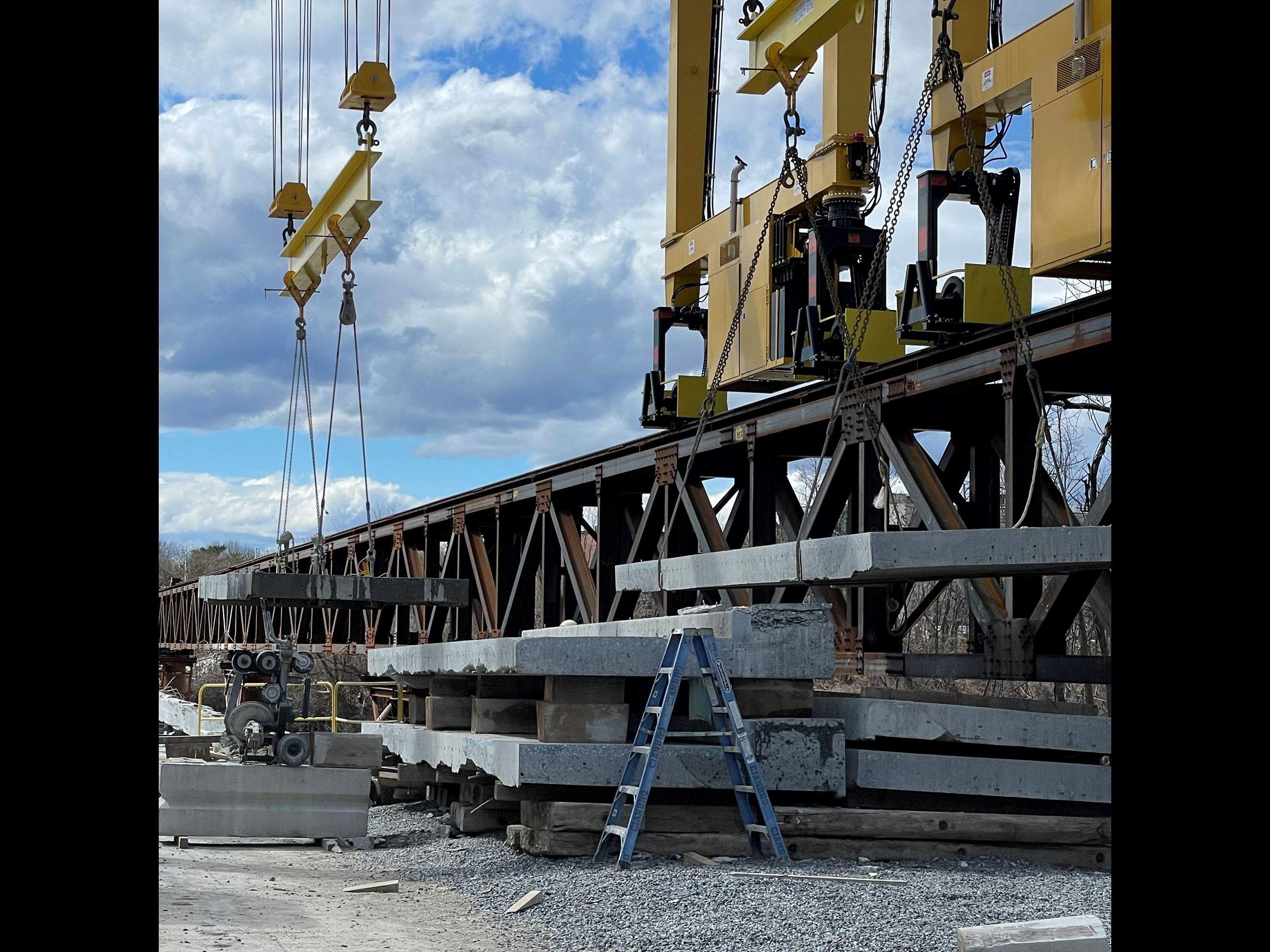

  1. 1 Ticonic Bridge
  2. 2 Ticonic Bridge
  3. 3 Ticonic Bridge
  4. 4 Ticonic Bridge

4/15/2024 through 4/19/2024

Site Activities as follows by Prime Contractor: Cianbro, Subcontractor: General Concrete Cutting

  • Finished Cutting and removing concrete on Winslow side of bridge.
  • Moved concrete cutting equipment to Waterville side of bridge.
  • Started demo on sidewalks, Spans 1 and 2 on.
  • Completed installing forms for 1st section of pier stem wall.

(MaineDOT Resident: Ben Walz)

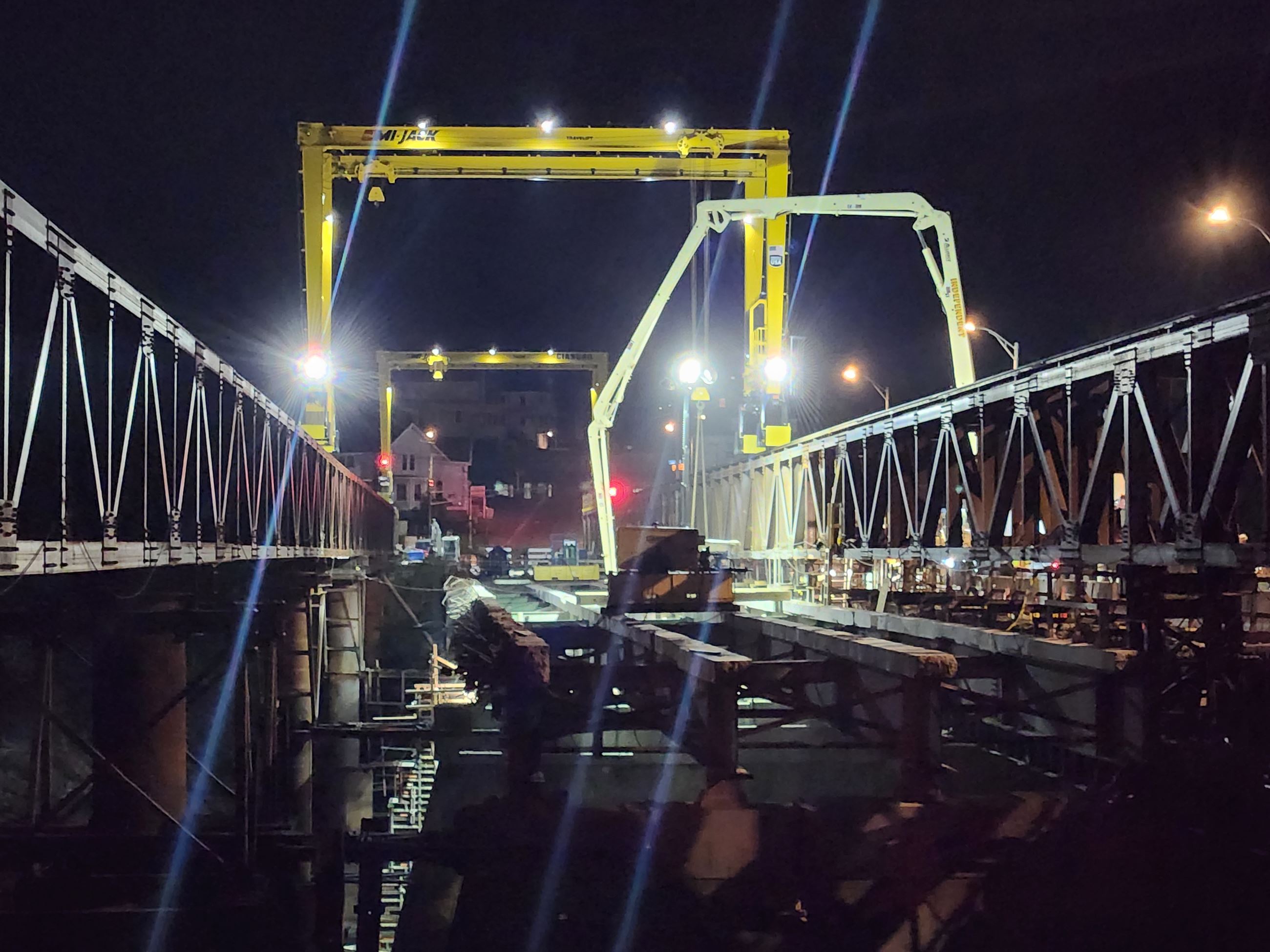

  1. 1 Ticonic bridge work
  2. 2 Ticonic Bridge work
