June/July 2024
07/29/2024 through 08/02/2024
Site Activities as follows by Prime Contractor: Cianbro and subcontractor: Suncoast Reinforcing LLC
- Began installing forms and rebar for abutment 1 back wall.

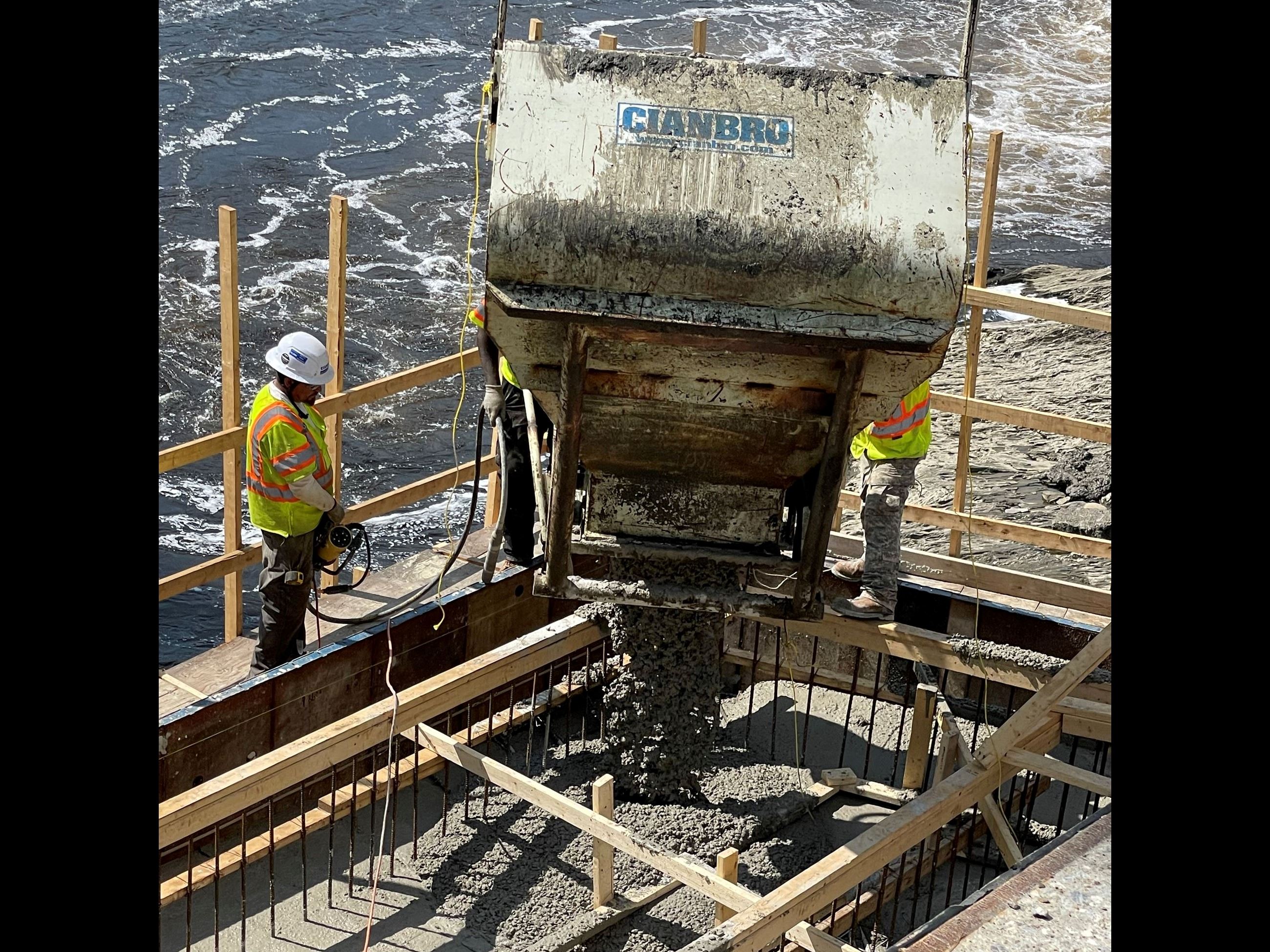

- Formed and placed concrete for abutment 2 breastwall and then pedestals.

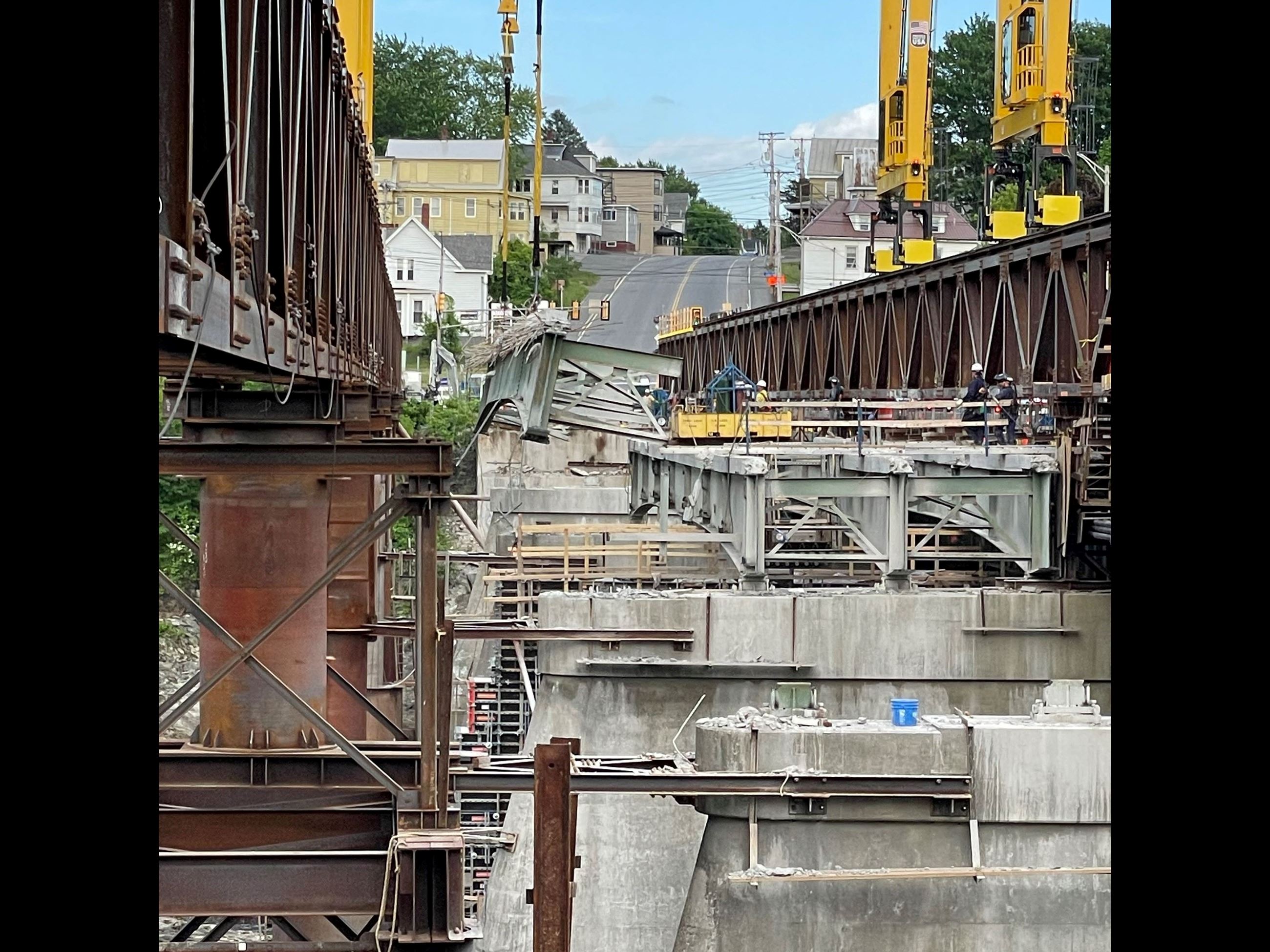

- Erected the center run of girders on the pier.
- Continued work on gantry foundation G-2.
(MaineDOT Resident: Ben Walz)
07/22/2024 through 07/26/2024
Site Activities as follows by Prime Contractor: Cianbro and subcontractor: Suncoast Reinforcing LLC
- Completed placement on abutment 1 pedestals.
- Started installation of form work and rebar for abutment 2 breast wall.

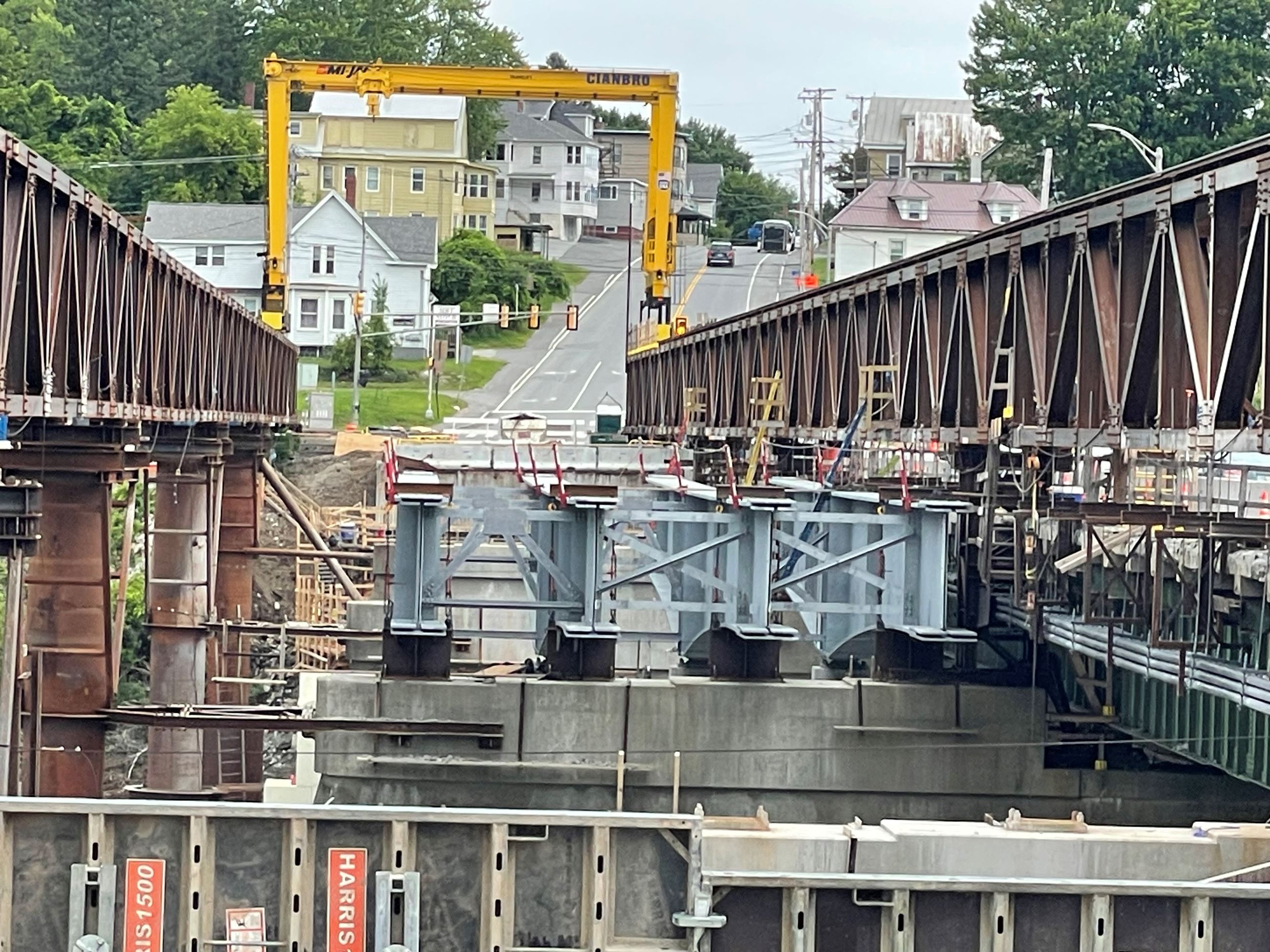

- Installed temporary bracing on median and existing piers in preparation for steel erection.
(MaineDOT Resident: Ben Walz)
07/15/2024 through 07/19/2024
Site Activities as follows by Prime Contractor: Cianbro and subcontractor: Suncoast Reinforcing LLC
- Completed rebar installation for abutment footings 1 and 2 and placed concrete.
- Continued working on gantry truss foundations C-2 and G-2.
(MaineDOT Resident: Ben Walz)
07/08/2024 through 07/12/2024
Site Activities as follows by Prime Contractor: Cianbro and subcontractor: Suncoast Reinforcing LLC

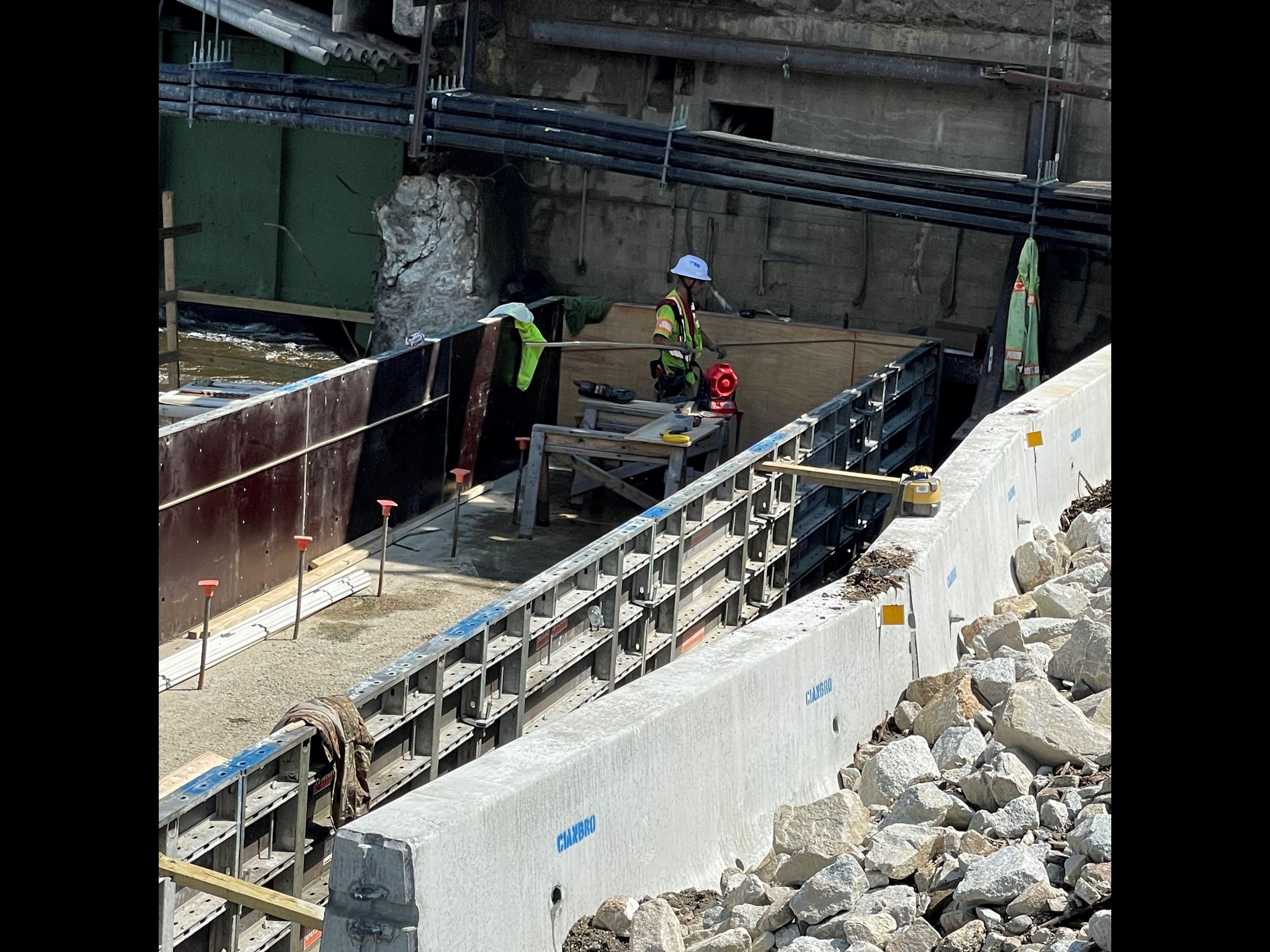

- Installing forms for abutment 1 and 2 footings and started installing rebar.
- Worked on gantry crane foundation locations C-2 and G-2.
- Started prep work for steel erection.
(MaineDOT Resident: Ben Walz)
6/24/2024 through 6/28/2024
Site Activities as follows by Prime Contractor: Cianbro and Sub Contractor: Suncoast Reinforcing, LLC
- Completed abutment 1 demo.
- Installing forms and rebar for abutments 1 & 2 sub footings.
- Installed bearings on pier and covered for UV protection.
(MaineDOT Resident: Ben Walz)
6/17/2024 through 6/21/2024
Site Activities as follows by Prime Contractor: Cianbro and Sub Contractor: Ranger

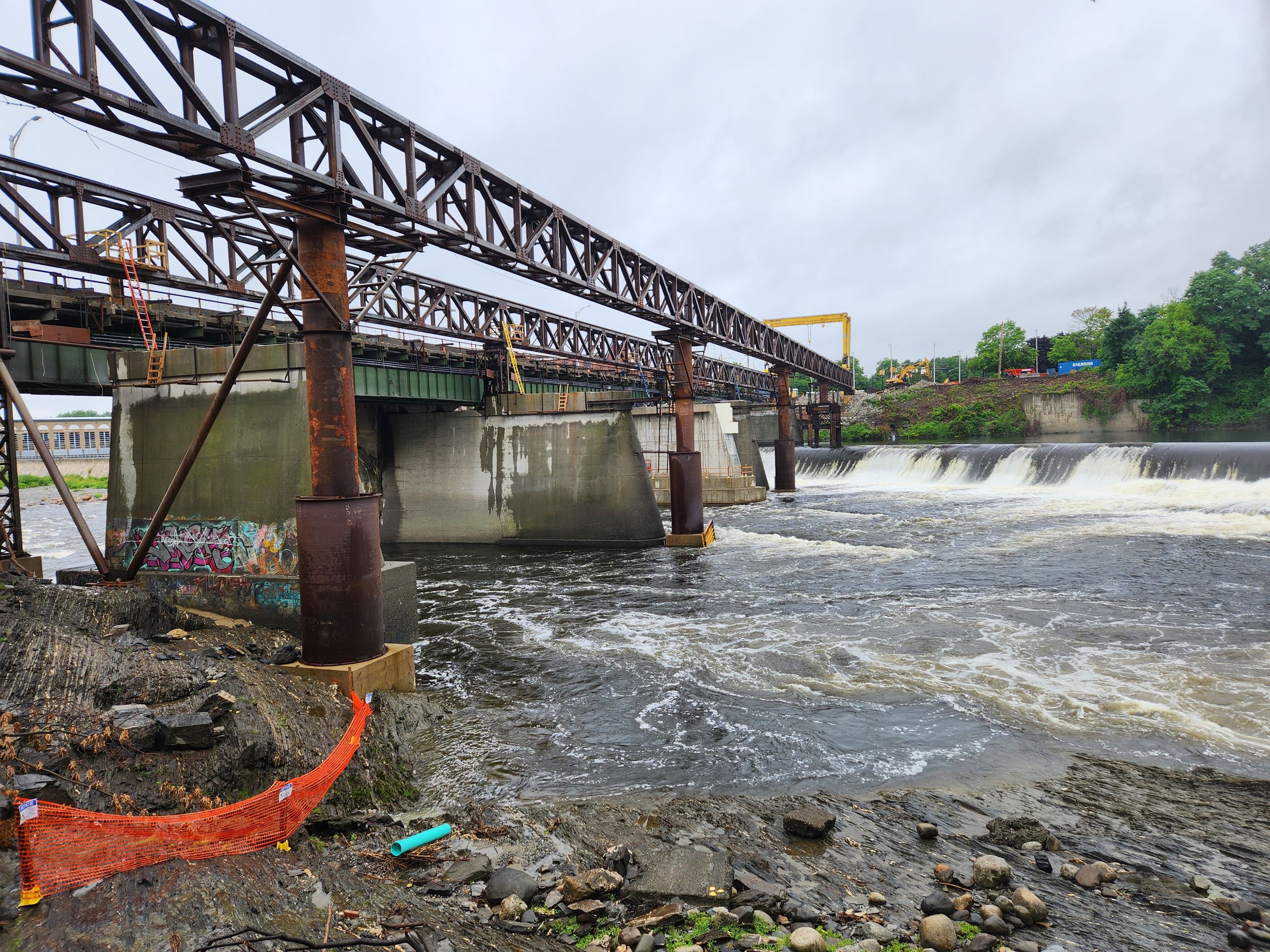

- Completed steel girder removal on westbound spans.
- Removed Pier stem forms.
- Continued Abutment 1 demo, and cutting micro piles to plan elevation.

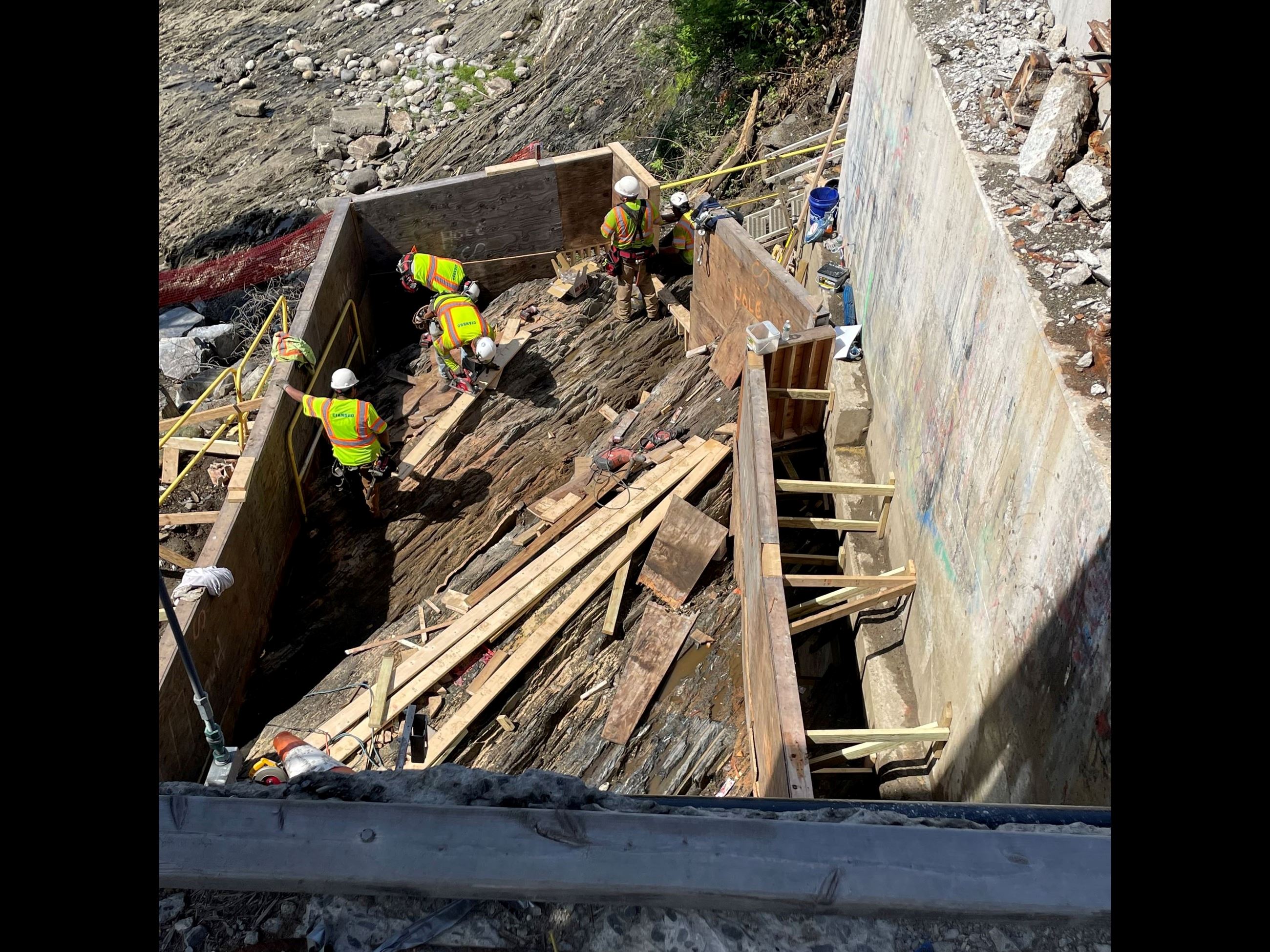

- Excavated to bedrock, pressure washing and cleaning bedrock for Abutment 2
- Installed access for existing piers for demo.

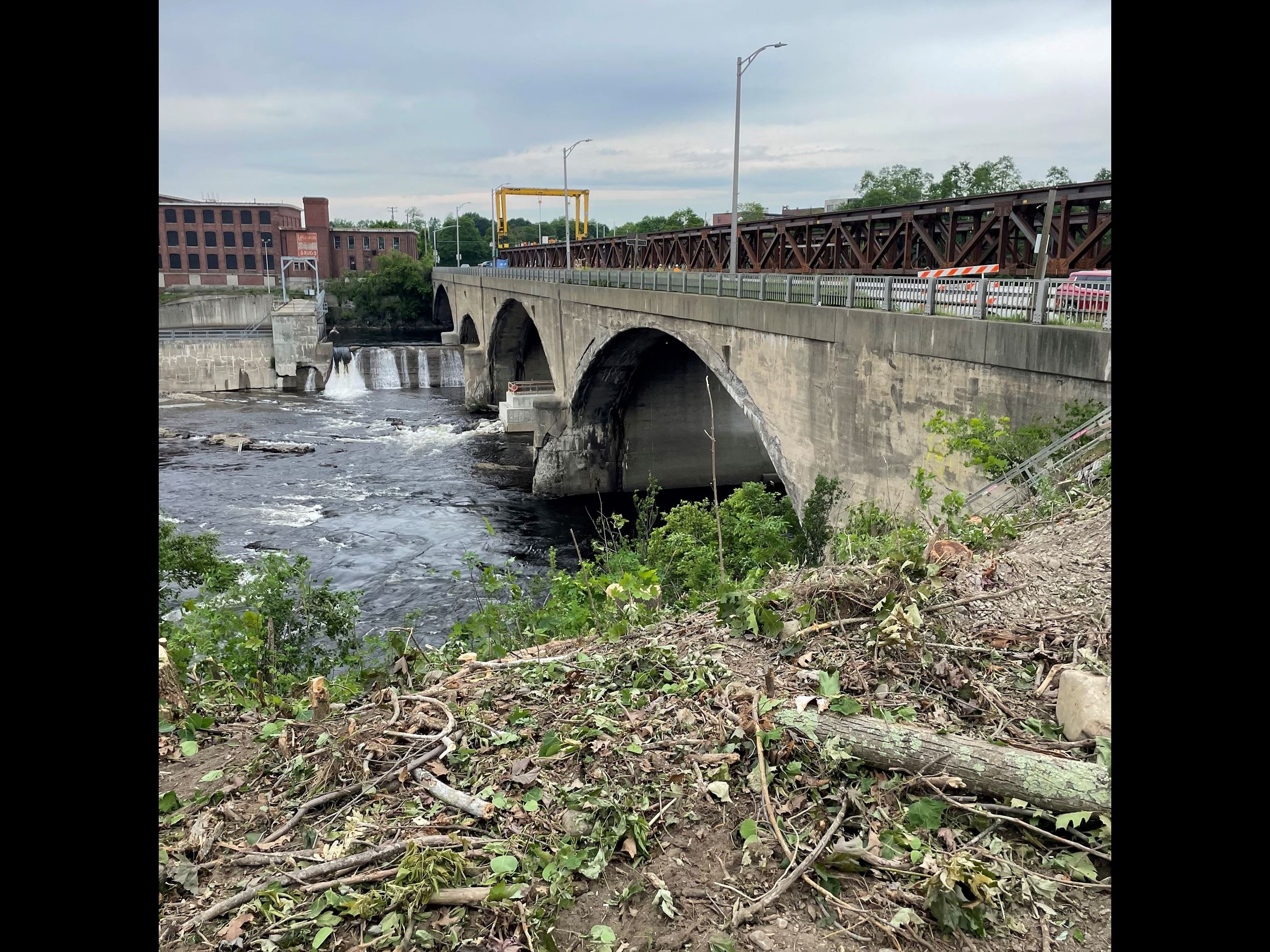

- Completed tree clearing in Waterville, mobilized to Winslow to continue clearing.
(MaineDOT Resident: Ben Walz)
6/3/2024 through 6/7/2024
Site Activities as follows by Prime Contractor: Cianbro
- Completed concrete placement for Phase 1 pier pedestals.
- Removed forms on the first lift of pier seal.
- Continued removing steel girders.
- Continued Abutment 1 demo and structural earth excavation.
(MaineDOT Resident: Ben Walz)
